Proving Fit-for-Purpose Monitoring Can Cost a Fraction of the Traditional Approach
For any CO₂ storage project, monitoring is not optional — it is a regulatory obligation that runs for decades, long after injection stops. But the cost and intrusiveness of conventional monitoring can be a major drag on project economics.
This techno-economic study by CO2CRC puts eight monitoring technologies on a like-for-like commercial footing, from established 4D seismic through to the innovative downhole seismic and pressure-tomography techniques developed at the CO2CRC Otway International Test Centre — and quantifies just how much can be saved by choosing the right monitoring strategy.

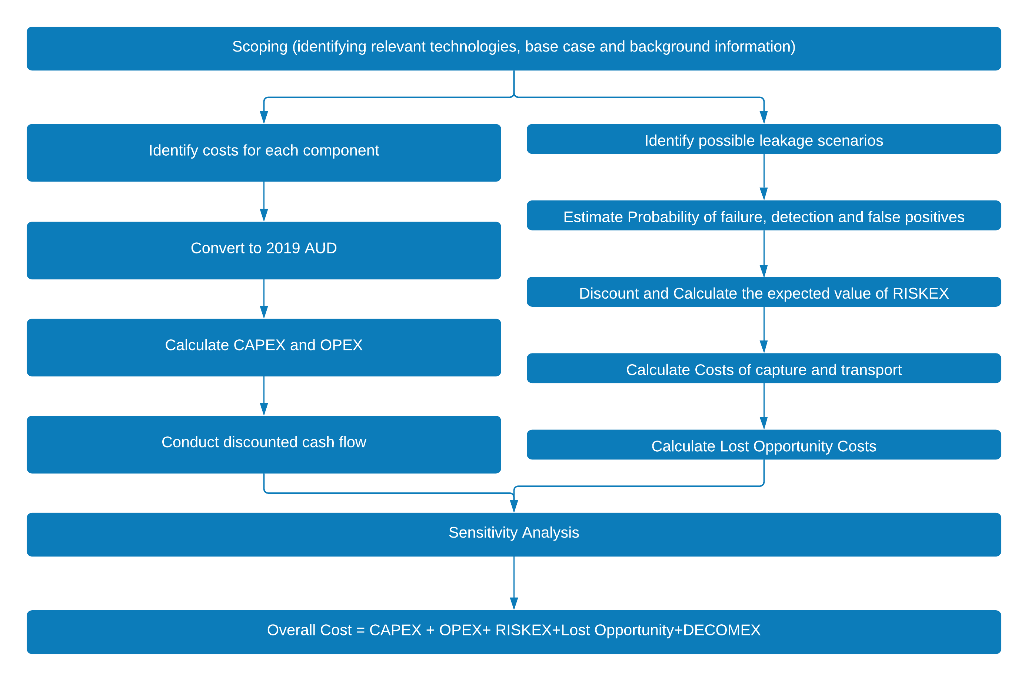

The techno-economic workflow: parallel costing of monitoring expenditure and risk-based expenditure, combined into a single whole-of-life cost.
Project goal
A Full-Lifecycle View of Monitoring Cost and Risk
This preliminary techno-economic assessment compares the whole-of-life cost of monitoring and verification (M&V) across a modelled CCS project of 25 years of injection followed by 25 years of post-injection monitoring. Crucially, it goes beyond simple capital and operating cost. It brings capture-and-storage risk into the same commercial frame — costing the expected consequences of a CO₂ containment (migration) event, and the lost-opportunity cost if a project has to be decommissioned early. All figures are reported on a 2019 AUD basis.
The analysis is powered by a purpose-built costing toolkit — the analytical engine behind CO2Tech's COSMIC costing software — which lets operators re-run any scenario for their own site geology, injection profile, risk appetite and economic assumptions.
What the assessment covered
- Eight monitoring technologies benchmarked head-to-head: 4D seismic, microseismic, temperature gauges, gravimetric analysis, InSAR and electrical resistance tomography (ERT), compared against the two novel Otway Stage 3 techniques — downhole seismic and pressure tomography.
- Three cost layers integrated into one number: capital expenditure (CAPEX), operating expenditure (OPEX), and a probabilistic risk-based expenditure (RISKEX) capturing the cost of detecting — or failing to detect — a leak.
- A risk-and-detection model built around each technique's real-world monitoring frequency and probability of detection, plus the cost of early vs late detection across six containment-failure scenarios.
- Sensitivity analysis on the assumptions that matter most — probability of detection, false-positive rates, and remediation costs — to show where the estimates are robust and where they hinge on further data.

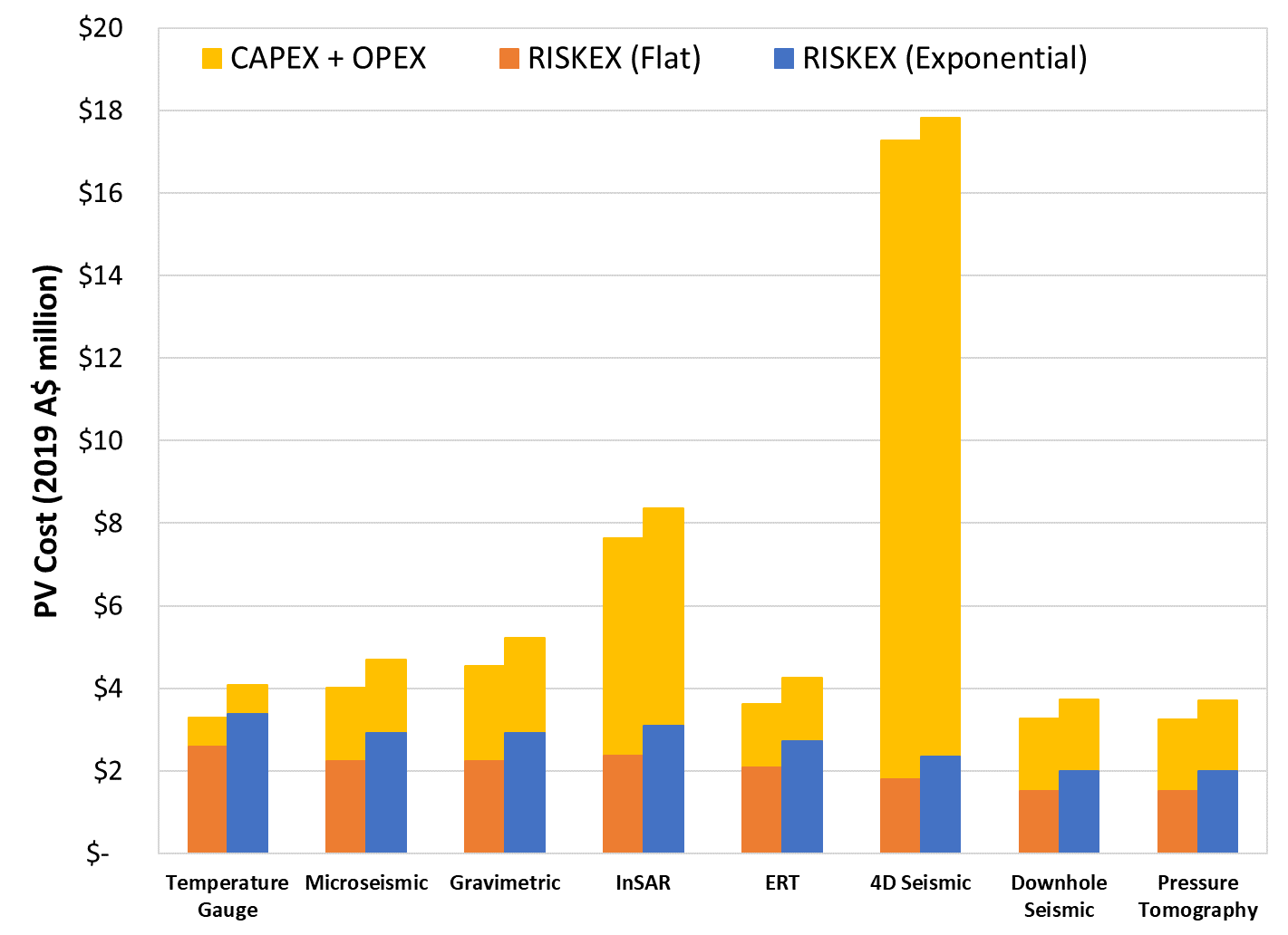

Whole-of-life monitoring cost including risk (PV, 2019 A$ million). 4D seismic dominates the cost profile, while the novel Otway Stage 3 techniques sit among the lowest-cost options.
Where We Found the Value
Beyond ranking the technologies, the study surfaces where monitoring dollars are actually won or lost — the difference between a generic cost estimate and a decision-ready assessment.
Innovative techniques deliver comparable accuracy at a fraction of the cost
- On basic CAPEX + OPEX alone, downhole seismic and pressure tomography come in at roughly 30 times lower cost than 4D seismic, while achieving a 0.9 probability of detection — versus 0.6 for 4D seismic — and monitoring every two years rather than every five.
- Because the novel techniques use permanently installed, subsurface infrastructure, they enable on-demand, near-real-time monitoring once in place, with lower community-engagement, environmental and societal costs than campaign-based surface seismic.
Bringing risk into the cost picture
- The study developed a defensible method to price the expected cost of a containment event (RISKEX) and the lost-opportunity cost of early decommissioning — costs usually left out of monitoring comparisons entirely.
- Sensitivity testing showed the results are far more sensitive to probability of detection and false-positive rates than to the remediation cost assumptions themselves — pinpointing exactly where better field data would most improve confidence.

The scenario that matters most: cost if a leak actually occurs. High-detection techniques — 4D seismic and the two novel methods — contain the consequences at the lowest cost.
The Bottom Line
4D seismic costs about 13× more than the two Otway Stage 3 techniques combined*.
*Low-cost scenario: ~A$79.2M for 4D seismic vs A$3.1M (downhole seismic) + A$2.8M (pressure tomography).
Under the high-cost scenario the gap is wider still: A$299 million versus A$11.7 million and A$11.4 million. Yet cost is only half the story. Because the novel techniques monitor more frequently and detect more reliably, they also perform strongly in the scenario that matters most — if a leak actually occurs, high-detection-probability techniques (4D seismic and the two novel methods) contain the consequences at the lowest cost. The Otway Stage 3 techniques therefore offer a rare combination: lower cost, higher monitoring frequency, and comparable or better leak-detection reliability.
For operators facing decades of monitoring obligations, that is the difference between monitoring as a compliance burden and monitoring as a managed, optimised cost.
Cost estimates are preliminary and accurate to approximately ±30% (2019 AUD basis). They are intended as a comparative decision-support benchmark, not a definitive project cost.
